Timesheets for high-end television

TL;DR

I implemented a new discovery project to help a delivery-focused team deliver a novel timesheets product, tailored specifically to UK film and television production.

As a result:

  • 75% of timesheets (about 1500 per week) are completed and submitted in less than 5 minutes
  • Our product-satisfaction scores are at an all-time high.
  • We have captured and prioritised nearly 900 user stories and mapped them across 50 jobs-to-be-done in a relational research system

Skip to: 💡 Discovery process 📐UI design 📈 Results 💬 User feedback

Background

Our strategy was to build a global production finance suite, enabling large studios (like Disney, Netflix, Apple) to hire, manage and pay everyone working across their productions - anywhere in the world. The product vision was simple; roll out our market-leading production management platform gloablly, then connect it to (interchangable) local payroll service(s) to enable us quickly roll out to new international markets.

Outside of the US & Canada, the UK is the largest territory for Film and Television production spend. Our US counterparts already have timesheets software - but the UK and US workflows are very different and it was decided that we would invest in building a novel service, rather than tailoring the US offering for a UK audience.

Challenges:

  • Users weren’t getting on with our existing timesheets product; crew (completing timesheets) found it particularly hard to use
  • Production teams were constantly needing to override incorrect calculations and, with a new PACT/BECTU (film and tv unions) agreement on the table - we needed to completely revise the underlying calculations engine
  • A number of large contracts were up for renewal and we needed to work quickly in order to retain current business
  • Another challenge was the shape of the team. I re-joined the company just as this project was due to kick off and my team consisted of myself (Lead Product Designer), two product managers (each with their own squad of developers) and two product owners (one to work with each of the PMs). As per the org chart, the team was incredibly delivery-focused. While they were all excellent generalists, conducting research was not a core skill for anyone on the team.

Objectives

After much consideration we settled on the following objectives for this project:

  • Maximise the Product-satisfaction scores for all key user personas, do this by:
    • Minimising the time it takes to complete a timesheet
    • Minimise the time it takes to approve timesheets
  • Increase the accuracy of timesheets, do this by:
    • Maximising the accuracy of all hours-to-gross calculations performed by our system
    • Minimise the number of manual overrides required
  • Maximise product differentiation from our competitors (give people a reason to switch to us)

Discovery

When I first joined the team, very little user research had been undertaken.

Instead, the PMs had focused on categorising inbound feedback into problem statements. While this gave us a solid foundation to start with, I felt uneasy building a completely novel solution solely through the lens of feedback on our existing product.

I created a new discovery process based on the jobs-to-be-done framework (to identify and prioritise the user needs) and a “definition of done” (to enable us to quantify what differentiated the MVP with the go-to-market version).

After aligning the SVP of Product, I worked to train the PMs on how to implement the process so that we could work in parallel.

Over the next 3 months:

  • We identified which of the personas were involved
  • We deconstructed the end-to-end process (contracts > timesheets > payroll) into more than 20 jobs-to-be-done
  • We conducated more than 30 hours of primary user research, creating and ranking more than 130 user stories

On-site in Bristol visiting a live production

My team enjoying a late breakfast before heading onto set.

The results

The results us to break the work into multiple phases Created a spreadsheet to toggle features in and out of scope Broke work into milestones

Spreadsheet used to calculate scope

Checking or unchecking a feature updated the matrices to show us which solutions would meet the conditions of the scope of work.

Kicking off the project

Brought the whole team together Walked through objectives, our findings and the tactical plan

Feature design and validation

From this point, the project really shifted into delivery mode and I needed to take 25 individual concepts from idea to solution.

To throw a spanner in the works, there were rumors circulating of an upcoming actors strike. So, coinciding with the end of the discovery process, the UK business decided to pivot to also delivering the first version of our digital Payroll service. Work was due to start on this in just 4 weeks time.

As the sole designer working across both teams, this gave me an incredibly short turnaround time to get initial designs validated and into development. Working closely with the PMs (and working four 80hr weeks in a row) we managed to make incredibly strong progress - 60% of the outstanding work had fully validated refernce designs and everything else was in-progress or descoped into a later milestone. This was achieved by creating open channels with a number of users and regularly re-prioritising what was next based on their feedback. We essentially created an asynchronous focus group of 8-10 Production Accountants and Production Managers who were giving us near real time feedback on the user experience.

[Here’s a short recap of the most impactful features from this period:][#ui]

Summary chips

User story(s)

  • As a member of crew, when I am completing my timesheet, I want to know exactly what I am claiming for so that I know I will get paid the correct amount.
  • As a member of the production management or finance team, when I am approving a timesheet, I want the totals to be broken down so that I can check for anything that I don’t expect

Solution

When testing with out existing components, users were getting confused about the information architecture of the summary (eg. which totals related to which category).

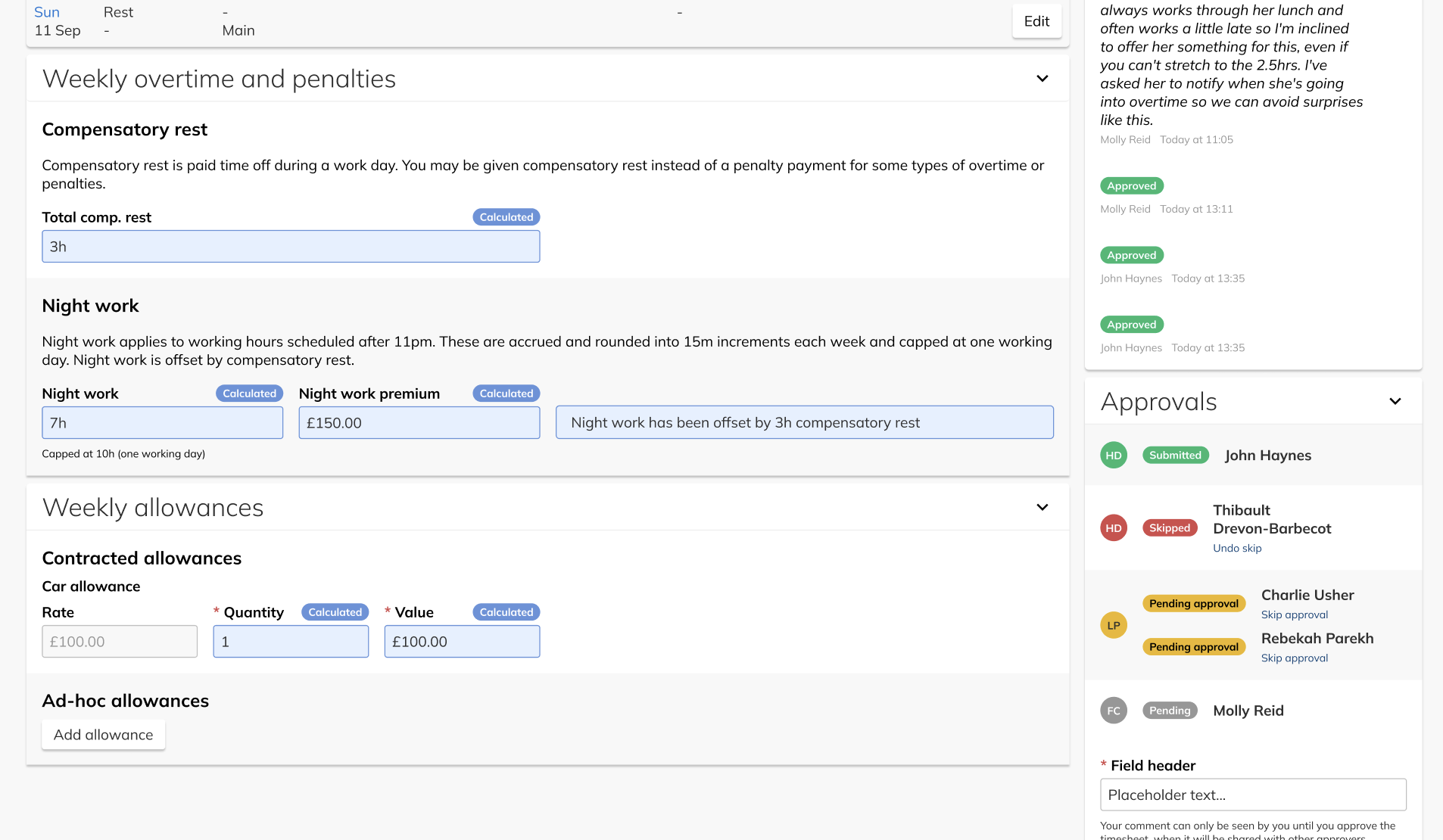

To resolve this, I designed a new component, “chips”. Chips enabled us to categorise and summarise the durations and financial totals on a timesheet; these components were then embedded into the individual day and weekly summary views:

  • Laid out to ensure that the financial total for each section is always visible and enhanced with progressive disclosure to show the detail
  • Embedded in a sticky panel that scrolls with the user, enabling them to view the detail of the timesheet and determine what contributes to the totals
  • Used accessible labels to highlight when something had been edited by an approver - when clicked, this opens a modal to show which days have been edited

Summary chips

This example shows the documentation from the component library.

Pre-populated timesheet

This shows the chips in-situ, scrollling alongside the view of a timesheets day.

Result

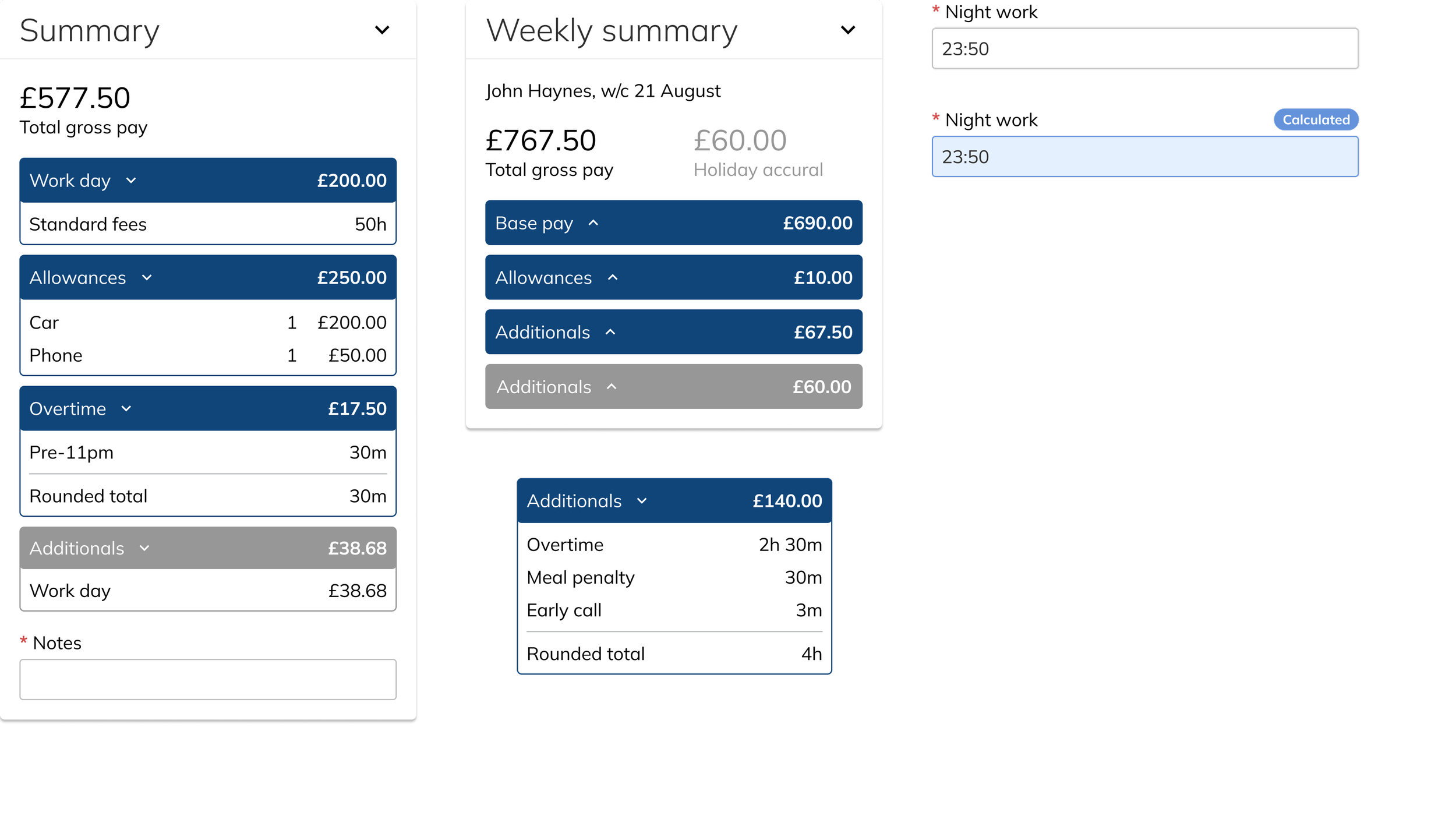

By implementing this feature:

  • 100% of test participants were correctly able to identify which totals belonged to qhich categories
  • We received multiple instances of positive anecdotal feedback for how timesheet approvers were using the summaries, “for most of the timesheets I don’t need to look any further than the summary”

Prepopulation of timesheets

User story(s)

  • As a member of crew, when I need to tell the Production Team how many hours I’ve worked I want to get it done quickly and accurately so that I can get back to my actual job.

Solution

Film and television production is run on a detailed and tight schedule; for the majority of the time, crew will use their timesheets to claim for their contracted hours (only 5-20% of timesheets claim overtime and other penalites each week). Armed with this information, we took the following approach:

  1. Enable the Production Office to upload the daily schedule
  2. Pre-populate timesheets for crew using a combination of their contract (for the days they are due to work) and the schedule (to determine the hours)
  3. The prepopulation was triggered each time the crew member went to view their timesheet (which was the only way they could submit), ensuring that the hours were always up-to-date (in case something had changed mid-week).
  4. An alert was added to show the crew member when a timesheet had been pre-populated

Pre-populated timesheet

An alert was added to the top of the timesheet page to let the owner know that their timesheet had been prepopulated.

Result

By implementing this feature:

  • The minimum number of steps required to complete a timesheet was reduced from 33 to just 2
  • 75% of our timesheets are completed in 5 minutes or less (about 1500 every week)
  • 72% of respondents (215 of 300 crew who completed the survey) agreed that Production Portal minimises the time it takes to complete their timesheet

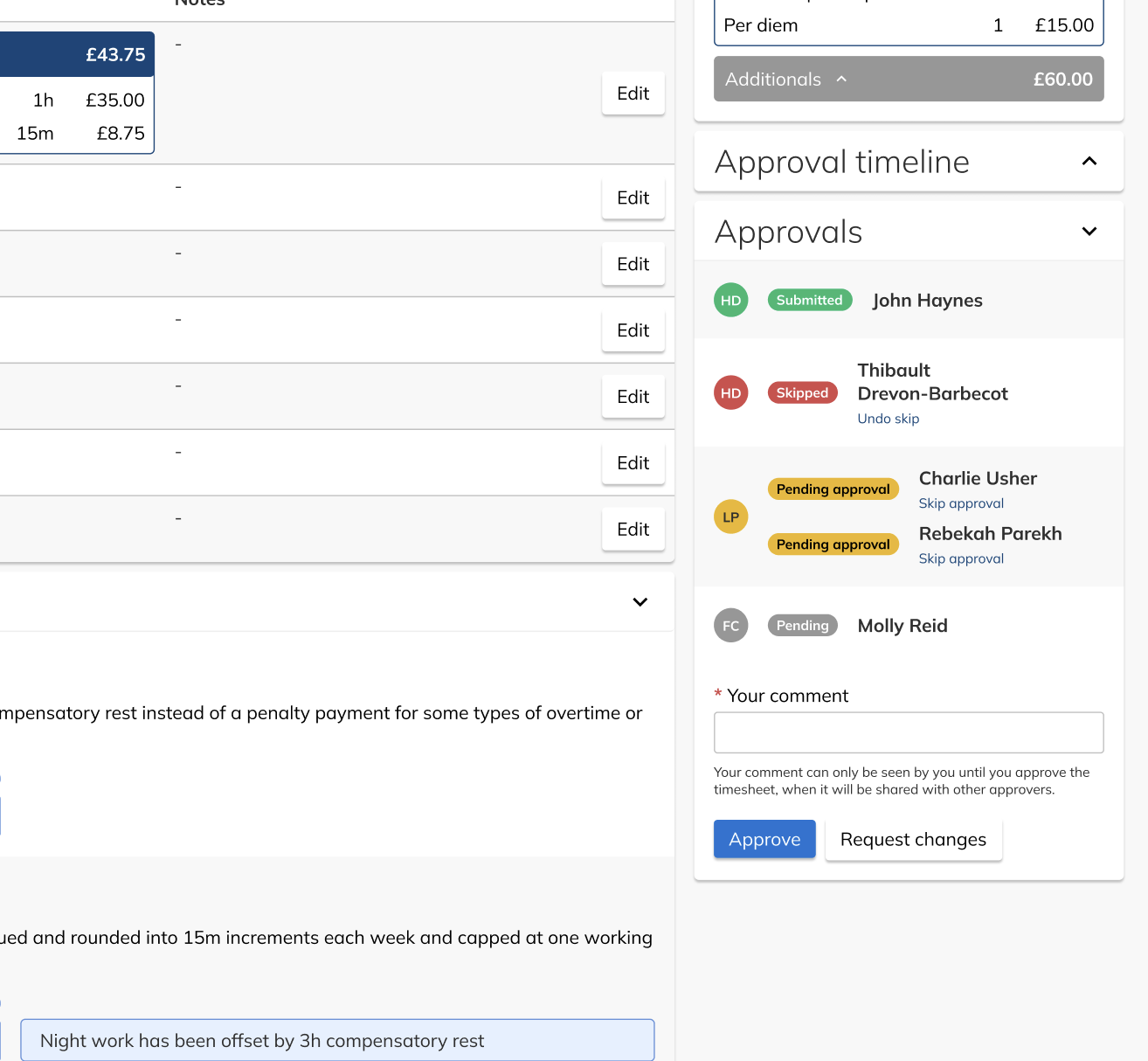

Edited fields

User story(s)

  • As a member of the production management or finance team, when something has been changed on a timesheet, I want to know what was changed (and by whom) so that I can assess whether or not I need to challenge or amend it.

Solution

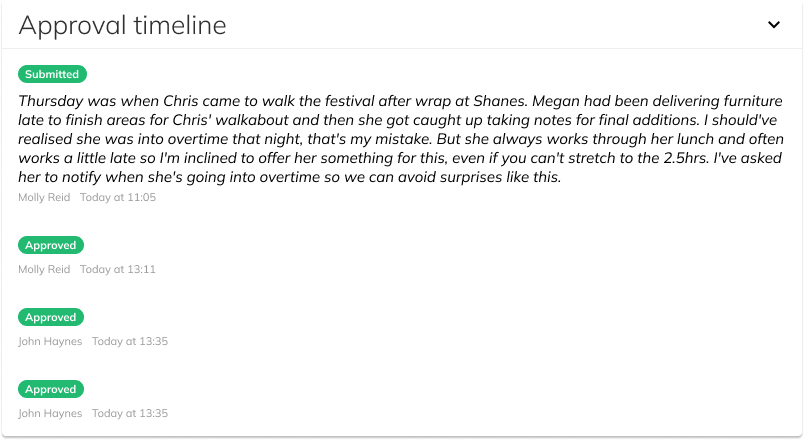

In the previous version of our timesheets feature, every edit or override made by approvers was added to a chronological timeline - every approver was able to view the entire history of what had changed. In theory, this should solve the problem - but in practice, when navigating between the weekly summary and an individual view of a day, approvers were getting frustrated about needing to remember the information.

When expanded, the timeline could be a very large (and, due to its size, significantly impact loading times). It wasn’t practical to add it to every screen.

Edited fields

Result

This feature was released in a bundle of other functionality, so it’s hard to demonstrate a direct and individual impact on any of the KPIs - however:

  • In testing, 100% of the participants preferred designs where the edited fields were used.
  • The bundled release had the biggest imapct on approval times and approver the PSAT score; the majority of timesheets (75%) are now approved within 2 hours of submission.

Summary and reflections

Overall, this project was an excellent way to get reacquainted with the team - and a good vehicle to kick-off the relational research system build.

Wins

  • All of the KPIs were met within 12 months
    • PSAT score of 4.4 out of 5 (target >4)
    • 75% of timesheets completed in less than 5 minutes
    • 72% of crew agree that Production Portal minimises the time it take to complete their timesheets
    • Average time to approve a timesheet is less than 24 hours
  • Implemented a novel product discovery process that has now been adopted across the company (now have nearly 900 user stories documented)
  • Up-skilled the product team and gave them transferable skills (and a framework/process that they could repeat independently)

Challenges and learnings

  • I should have done more to avoid the four 80hr weeks of design work; the business pivot definitely changed the timelines, but I think two days of up-front prioritisation and analysis would have meant I could have put forward a stronger case for pushing more of the work into a later scope.
